Its time to look at Baykar Defence numbers again.
Baykar announces in 11/2022
View attachment 50330
The last update:
04/2022

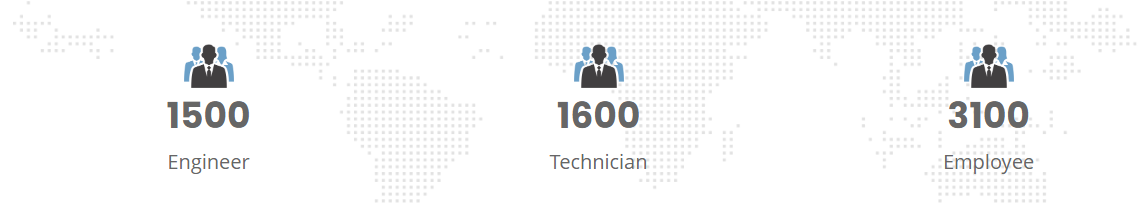

Employee Count "2300 Employees"
Which implies an increase of 800 Employees in ca. 7 Months.
That would be approximately a calculated yearly increase of 1370 Employees.
> The Update implies that the previous post was about right and Baykar seems to be going for 1200+ New Employees per Year for the time being.
Baykar is International as well:
"We already host a number of international personnel from 4 different continents and nearly a dozen countries."
Keep in Mind that the new 3rd Expansion of Baykar isn't realized yet. The 4th Expansion will likely be in Ukraine near Kiev.
The 3rd Expansion is going slowly as far as I can tell.
The Satellite Pictures are from 05/2022 and 11/2022 Respectively.
View attachment 50331
View attachment 50333
I found an Interesting Blogpost. Somebody has been looking very deep into Baykar.
A nice read.

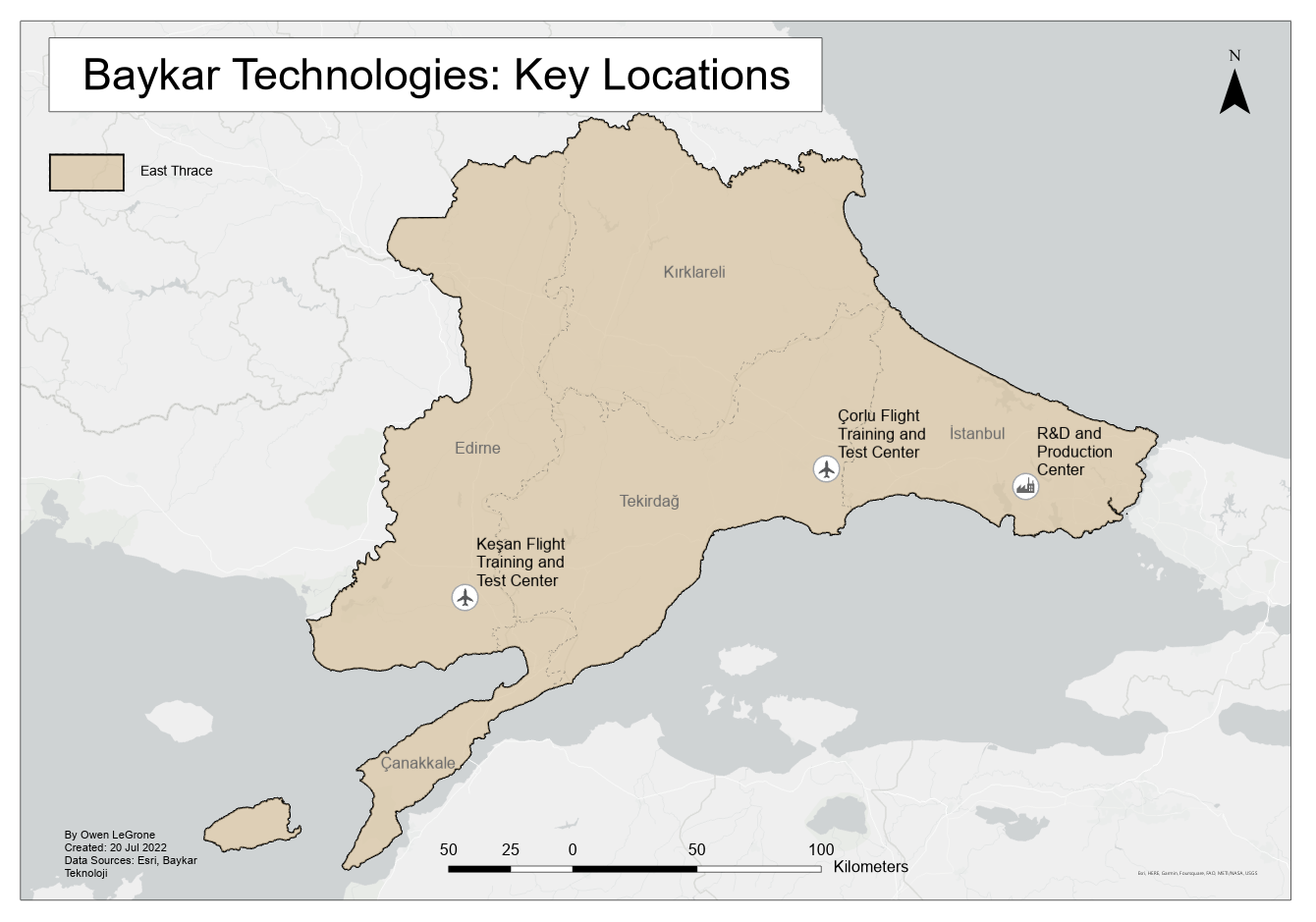

View attachment 50338

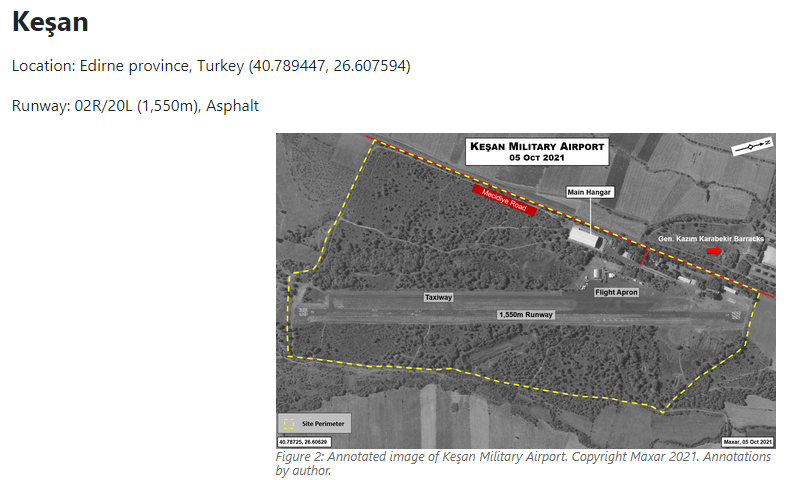

Kesan.

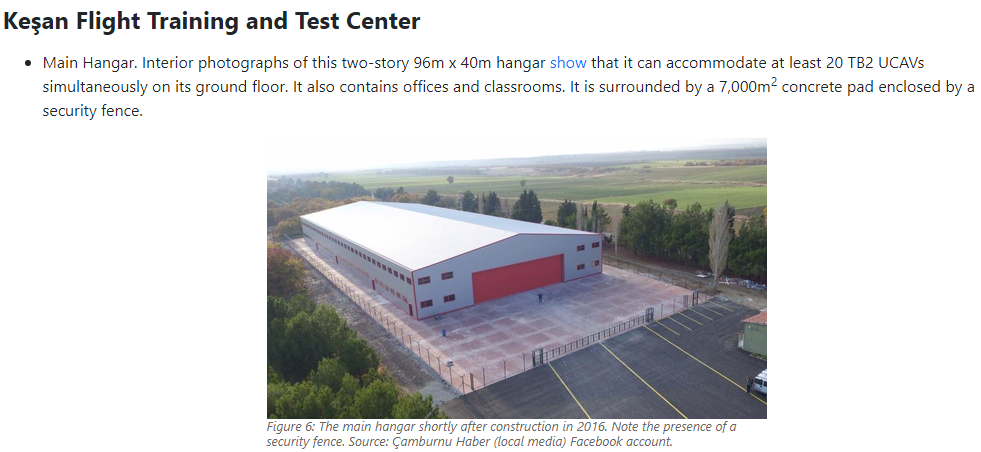

Current Disposition
Baykar operations encompass the entire area of Keşan Military Airport, which contains the Keşan Flight Training and Test Center. The airport is surrounded by open fields and has no security fence, although the main hangar building is fenced. The site is approximately 144km from Çorlu along the E84 highway and 207km from Esenyurt along the E84 and E80 highways.
Operational Capacity

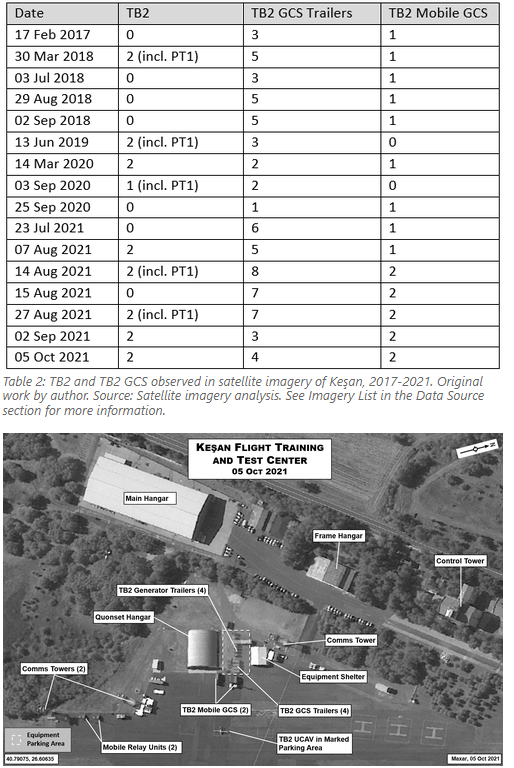

Keşan likely has the ability to store approximately 30 TB2 UCAVs in five hangars (see estimates below). One or two TB2 UCAVs have been visible in nine out of 16 satellite imagery captures of the airfield from 17 Feb 2017 to 05 Oct 2021, suggesting steady rotation of aircraft in and out of the hangars, with aircraft emerging shortly before they fly and returning afterwards.
Future Activity
More enlargement of existing site infrastructure is highly likely over the next two years, considering estimated increases in TB2 production. This may include additional support buildings and enlargement of the apron. Any construction on the eastern side of the airfield is likely to come at the expense of the remaining military structures there.
This site is likely to host the Bayraktar TB3 UCAV, an advanced and heavier derivative of the Bayraktar TB2, for flight testing and possibly training operations. Baykar
plans for this UCAV to make its first flight in late 2022. Keşan is logically preferable as a TB3 host to the other Baykar test site, Çorlu, because of its existing association with the similar TB2 program. Baykar-owned TB2 testbed “T-PT1” and several serial production TB2s underwent intensive
testing at the site during 2022; this included touch-and-go landings common in carrier operations. The additional 250m of runway length added between 25 Sep 2020 and 04 Dec 2020 was likely planned in expectation of the TB3 as well. This UCAV has a maximum takeoff weight (MTOW) of
1450kg, over twice the
700kg MTOW of the TB2, and logically will require additional space to become airborne.

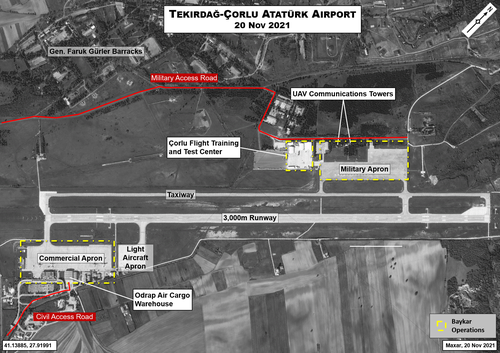

View attachment 50336
View attachment 50335
View attachment 50337
Corlu
Operational Capacity
The three hangars within Çorlu Flight Training and Test Center can likely accommodate five to seven Akıncı UCAVs at once. If additional space is required, Baykar has been known to use the northern military apron as a parking area. Seven Akıncı were

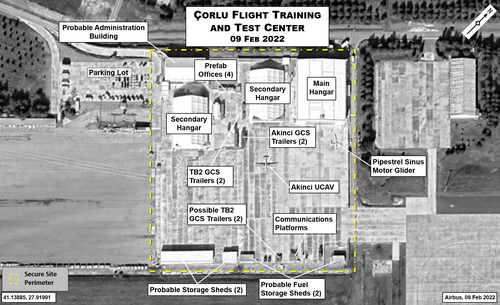

seen there in July 2022 for an “elephant walk” photoshoot. A pre-existing hangar on this apron can likely also host aircraft. No TB2 UCAVs have yet been identified in satellite imagery of Çorlu.
Both Akıncı and TB2 GCS trailers are visible in satellite imagery of the site. On 16 Nov 2020 and 05 Dec 2020, a single Akıncı GCS trailer and two TB2 trailers were visible. On 25 Mar 2021, the number of TB2 GCS trailers increased to four and a Sinus motor glider was seen parked in the open for the first time. The latter aircraft appeared in the next two consecutive captures as well. On 09 Feb 2022, one Akıncı, two Akıncı GCS, and two TB2 GCS (possibly four) were visible. While this possibly indicates a rising operational tempo, more observations would be needed to determine a clear pattern.
Future Activity
Additional enlargement of the existing infrastructure at Çorlu is likely over the next two years, considering estimated increases in both Akıncı and TB2 production (see Production section in
Part II). This may include additional support buildings and new apron space within the Çorlu Flight Training and Test Center. It is also possible that new facilities will be constructed along the military apron. Any construction at either location is likely to take place on land associated with the Gen. Faruk Gürler Barracks.
This site is likely to host the Bayraktar Kızılelma UCAV when it begins flight tests in 2023. Keşan, the only other Baykar-operated test facility, is unlikely to have adequate runway length for this aircraft. The known MTOW of the
Kızılelma is 6 tons (5,443kg), significantly higher than the TB2 (700kg) but less than the
Akinci (6,000kg), which already operates from Çorlu. Additionally, the Kızılelma will be powered by a
turbofan engine, necessitating on-site jet fuel storage. Çorlu possesses a POL farm with jet fuel storage tanks while Keşan does not.
View attachment 50339
View attachment 50340

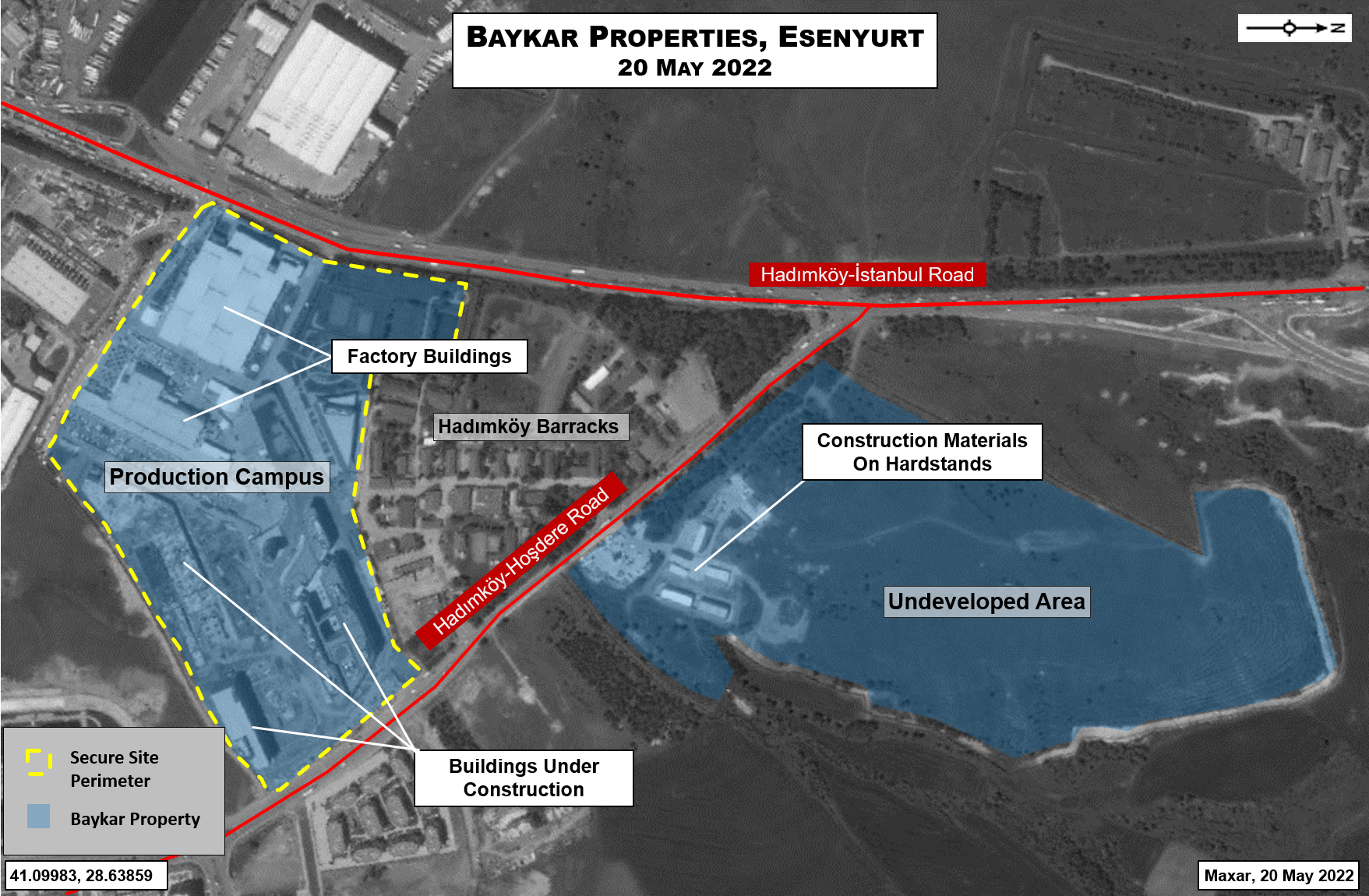

Esenyurt (R&D Centre)

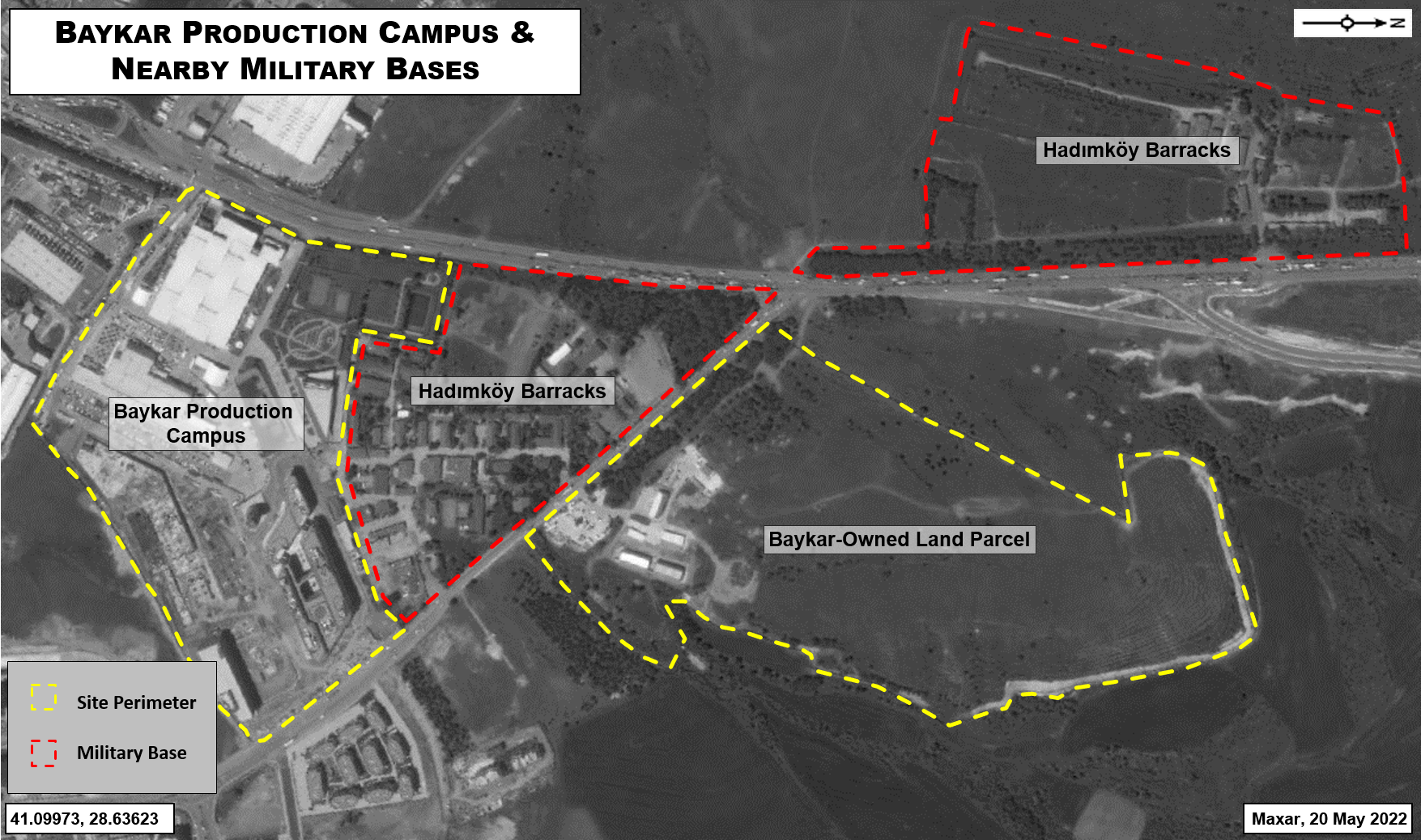

View attachment 50341
View attachment 50343
View attachment 50344
Future Activity
- Three new buildings were visibly under construction at the original Baykar-owned property in Esenyurt in imagery dated 17 Jul 2022. All are likely to be completed in the next one to two years.
- A building with a foundation footprint measuring approximately 14,600m2. This is the most recent building to begin construction, between imagery dated 14 Jan 2022 and 20 May 2022, and the only one to remain unidentified. It is likely a third factory building. Haluk Bayraktar cited plans to create additional production space in Esenyurt on 29 Jan 2021, following the construction of the main and second factory buildings.
- The Özdemir Bayraktar National Technology Center.
- A probable multistory parking garage.
- Construction had not yet begun at the more recently acquired property. However, the appearance of construction hardstands, storage containers, and vehicles suggests that it is imminent.
- It is likely that, with the completion of additional parking space, the test track will undergo more use in its intended purpose. Initially unobstructed, observations on 03 Aug 2021, 14 Jan 2022, and 25 Jun 2022 indicated that it was being used as a carpark, likely to add employee parking capacity before more permanent facilities were built. Other areas to the east of the main factory and around the periphery of the second factory may also be cleared, enabling them to be devoted solely to open storage of material components, waste materials, and finished products.
- It is likely that the entrance to the Özdemir Bayraktar National Technology Center, which borders the Hadımköy-Hoşdere road from the east side of the land parcel, will become the new main entrance to the campus. Architectural renditions indicate that this entrance will branch into two access roads, one for staff and the other for visitors. Heavy delivery vehicles will likely continue to use the current southern entrance, as this provides better access to the factory buildings within the campus.
- On 17 Jul 2022, all of the land on the original Esenyurt land parcel had either already been developed or was the site of active construction. Any new buildings will likely need to be built on the second property. Whether this area will host additional factory buildings, administrative buildings, or other structures is unclear.
